BIS Certification Processing Time: 3 Critical 2026 Timelines

bis certification processing time

BIS certification processing time depends entirely on the scheme. CRS registration typically takes four to eight weeks. An ISI Mark licence under Scheme I typically takes thirty to sixty days. FMCS for a foreign manufacturer typically takes four to six months, because a BIS officer must inspect the overseas factory. The application form takes an afternoon, and the laboratory takes weeks. If you are working to a vessel date, see our BIS Certification Services.

Roughly half of any timeline is queue time you cannot compress, and understanding that split is the fastest way to read BIS certification processing time correctly. The other half is preparation quality and response speed.

Who This BIS Certification Processing Time Guide Applies To

This guide is for manufacturers and importers planning launches, shipments and tender deadlines around certification. It gives realistic ranges, a stage level breakdown, and the delays you can actually control. The steps themselves are covered in a separate guide. For clearance planning alongside it, see our Import Export Consultancy Services.

BIS Certification Processing Time by Scheme

SchemeBest caseTypicalSlow case
Scheme II, the CRS4 weeks6 to 8 weeks12 weeks plus
Scheme I, the ISI Mark30 days45 to 60 days90 days plus
FMCS, foreign manufacturers4 months4 to 6 months9 months plus

Best case BIS certification processing time assumes a ready factory, an available laboratory slot and same day responses to BIS. Very few first time applicants hit it. Confirm current scheme conditions on the Bureau of Indian Standards site before planning.

Where the Time Actually Goes

StageCRSScheme I (ISI)FMCS
Applicability and standard selection2 to 5 days2 to 5 days3 to 7 days
Technical file preparation3 to 7 days7 to 14 days14 to 21 days
Factory readiness workNot applicable0 to 30 days0 to 45 days
Laboratory queue and testing15 to 35 days15 to 30 days20 to 40 days
Application scrutiny7 to 15 days7 to 15 days15 to 30 days
Factory inspection schedulingNot applicable10 to 25 days30 to 90 days
Grant and documentation3 to 7 days5 to 10 days10 to 20 days

Two rows dominate BIS certification processing time. Laboratory queue dominates the CRS, and inspection scheduling dominates FMCS.

Factory readiness can be zero. A plant with a working in house laboratory skips the longest avoidable delay.

What changed in 2026: longer licence validity under the 25 February 2026 amendment does not shorten grant times. It does add an annual fee deadline, and a suspension for non payment lasts ninety days. A suspended licence stops clearance immediately, which is a delay no schedule absorbs.

Planning Backwards From a Vessel Date

Importers should build the schedule from arrival, not from application, since that is how BIS certification processing time actually gets absorbed into a shipping plan.

  1. Fix the target arrival date at the Indian port.
  2. Subtract transit time to get the required shipping date.
  3. Subtract production and packing time.
  4. Subtract the certification duration for the applicable scheme.
  5. Subtract two weeks of buffer for deficiencies.
  6. The result is your latest safe application start date.

For a CRS product arriving in twelve weeks the window is already tight. For an FMCS product, twelve weeks is not feasible.

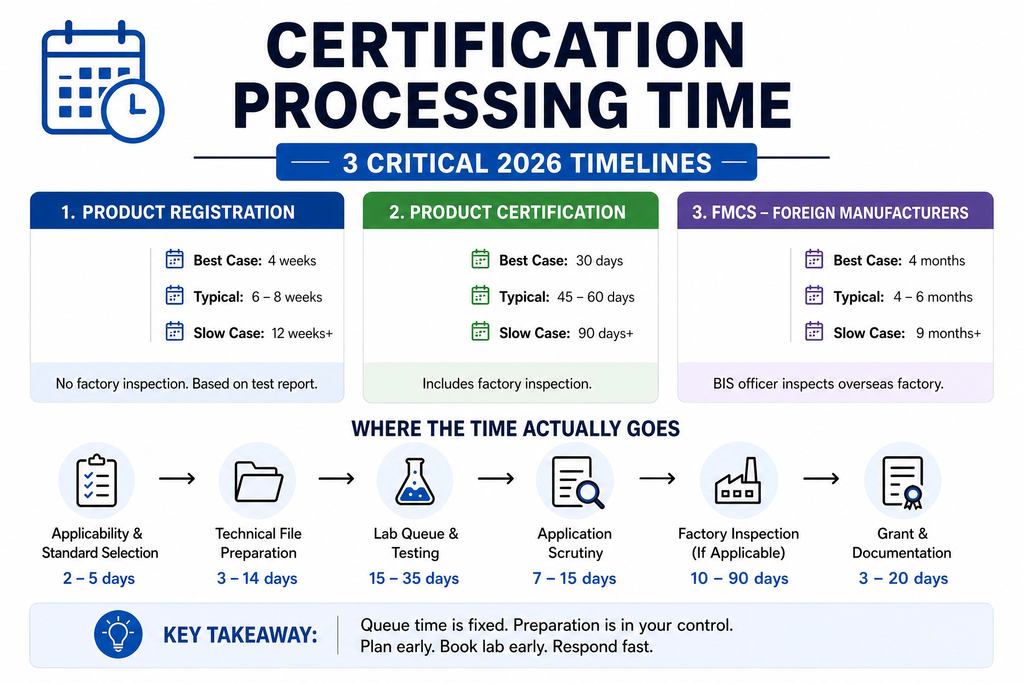

BIS Certification Processing Time overview

A Worked Example

A lighting importer plans a first shipment for a festival launch.

MilestoneWeeks before arrival
Application start20
Test report expected14
Registration granted10
Artwork printed, production starts9
Goods ready and shipped4
Arrival and clearance0

The schedule looks comfortable until the laboratory quotes a five week queue, a reminder that BIS certification processing time rarely follows the paper plan. That single variable consumes the entire buffer.

Booking the laboratory slot at week 20 is what protects the launch.

Where Delays Hide in Your Own Process

Applicants blame the regulator for delays that started internally, but internal habits explain most avoidable BIS certification processing time. Four internal habits cost weeks.

  • Sequential approvals. Documents wait in a signature queue while a deficiency window closes. Give one person authority to release the same day.
  • Late specification freezes. Engineering changes a rating after the report is drawn, so testing repeats.
  • Split ownership. Purchase holds the supplier relationship, quality holds the records, and nobody owns the deadline.
  • No calibration calendar. An instrument certificate expires the week of the inspection, and a second visit is scheduled.

Fixing these four costs nothing. They routinely remove three to five weeks from a first application.

How to Compress a BIS Timeline

  • Book the laboratory slot at the start, not after filing, the single biggest lever on BIS certification processing time.
  • Fix the model list before testing so one report covers the range.
  • Complete factory readiness before the application, not after scrutiny.
  • Nominate one internal owner who can release documents the same day.
  • Prepare labelling artwork in draft so only the number needs inserting.
  • For FMCS, appoint the Authorized Indian Representative on day one.
  • Verify laboratory scope for the exact IS code before drawing samples.

The full sequence is set out in our BIS certification process step by step guide.

Timelines for Common Situations

SituationRealistic expectation
Adding a model to an existing licence2 to 6 weeks
Renewal with no product changeWeeks, if fees and production data are current
Reapplying after rejectionRestart, assume the full original range
Retesting after a standard revision3 to 8 weeks depending on laboratory queue
Certification with goods already at portToo slow to help, assume demurrage

That last row is why importers should verify supplier licences before the purchase order. See BIS certification for importers in India.

Common Errors That Extend BIS Certification Processing Time

  • Booking the laboratory late: the queue, not the form, sets your date.
  • Adding models after testing: a fresh report and a fresh queue follow.
  • Discovering factory gaps at inspection: a second visit costs weeks.
  • Holding deficiency replies for internal sign off: windows are finite.
  • Reprinting artwork after a marking correction: production stalls behind it.
  • Assuming higher fees buy priority: government processing is not accelerated by payment.

Fee amounts and concessions are covered in BIS certification fees India.

How JPARKS Helps With BIS Certification Processing Time

If you take away one thing about BIS certification processing time, let it be this. Three points are worth carrying away. Queue time is fixed and rework time is not, so preparation is the lever. Laboratory capacity, not paperwork, sets the CRS timeline. Goods already at the port cannot be rescued by starting certification now.

JPARKS INDIA handles BIS certification alongside ICEGATE registration, AD Code mapping, IGCR clearance and Importer of Record work. We have served 500+ importers and exporters since 2018. Our team carries 40 years of EXIM experience and a 5.0 Google rating. We plan certification backwards from the clearance date.

Send us your target arrival date and the product, and we will map out the realistic BIS certification processing time before you commit. Visit JPARKS INDIA or use the Contact Page.

Frequently Asked Questions

Q1. How long does BIS certification take in India?

CRS registration typically takes four to eight weeks. ISI Mark licences typically take thirty to sixty days. FMCS typically takes four to six months.

Q2. Why does FMCS take so much longer?

A BIS officer must travel to inspect the overseas factory. Scheduling that visit, plus the bank guarantee and documentation, adds months.

Q3. Can BIS certification be completed in one week?

No. A filing can be made in a week, but a grant cannot. Any one week promise about BIS certification processing time describes the application, not the outcome.

Q4. What is the fastest BIS route?

The Compulsory Registration Scheme, because there is no factory inspection. Timeline then depends almost entirely on the laboratory queue.

Q5. How long does a renewal take?

Far less than a fresh application, provided annual fees and production statements are current. Neglected accounts become recovery exercises.

Q6. Does an MSME concession affect timing?

No. It reduces fees, not processing time, and it must be claimed at filing.

Q7. What is the single biggest cause of delay?

Laboratory queue time, followed closely by deficiency loops caused by inconsistent documents.

Q8. Can paying more speed up BIS approval?

No. Government fees are fixed by notification and buy no priority. Treat any claim of influence as a warning sign.
